Calendar background

Working Days Calculator

FOR Australia

TAKING THE UNCERTAINTY OUT OF DEADLINES

Start Calculating

Head Contractor:

SOPA Payment Schedule Response Deadline (NSW)

Scenario

A head contractor receives a payment claim on 18 December 2025 for a Sydney project. Under the NSW Building and Construction Industry Security of Payment Act 1999, a payment schedule must be served within 10 business days after receipt. Time does not run during the statutory shutdown (27-31 December). If the schedule is late, the contractor is deemed to have accepted the claim and must pay the full amount.

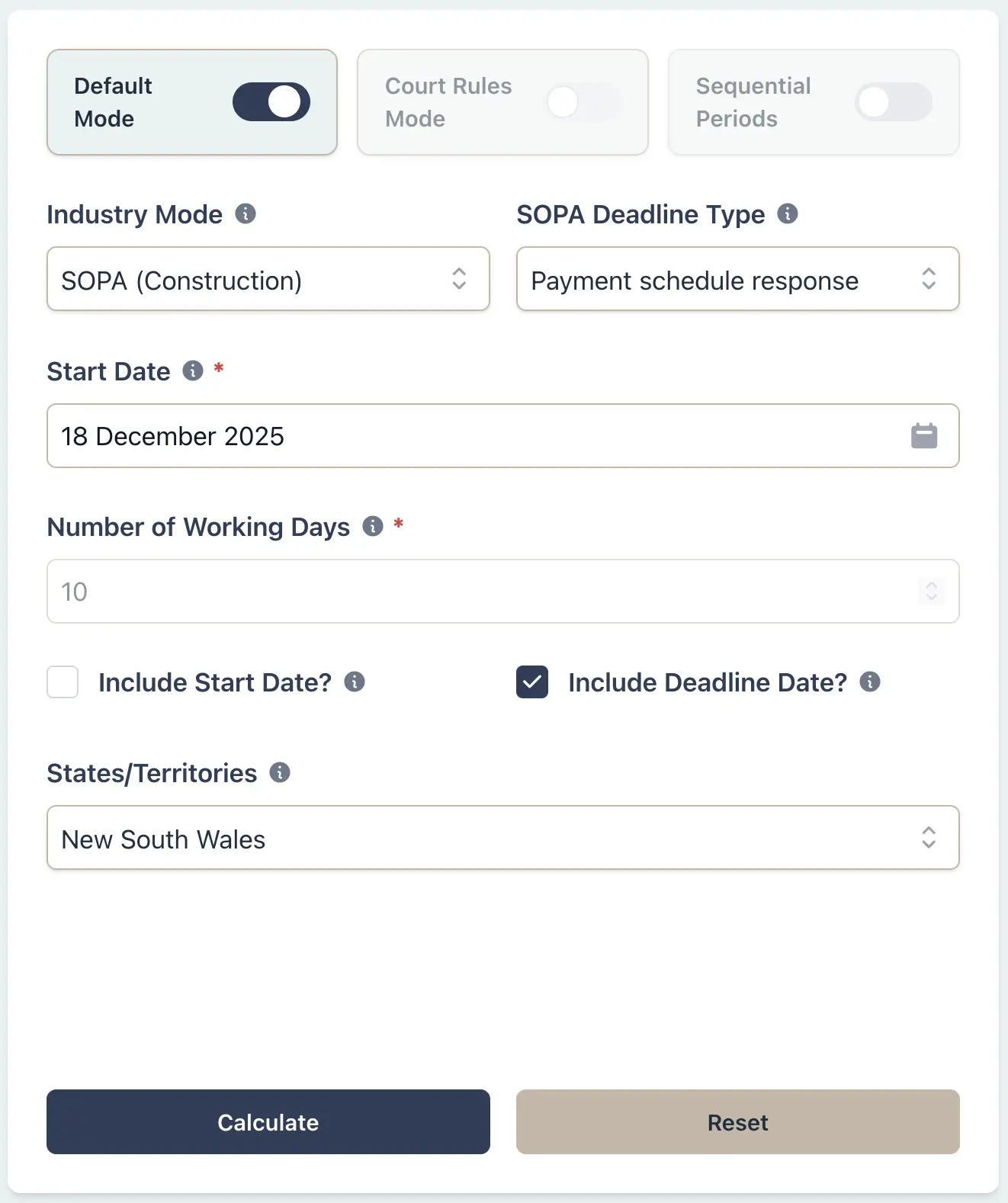

NSW SOPA payment claim response scenario setup

Example Workflow

1
Stay in Deadline mode (not Court Rules or Sequential)
2
Set Industry Mode to "SOPA (Construction)"
3
Select "Payment schedule response" as the SOPA deadline type
4
Select NSW under States/Territories
5
Enter the payment claim service date (18 December 2025) as the Start Date
6
Confirm the calculator sets 10 working days and applies the NSW/SA/ACT shutdown window automatically
7
Click Calculate to determine the response deadline

Result Example

Payment claim received: 18 Dec 2025
Response deadline: 10 business days (excluding 27-31 Dec shutdown)
Final deadline: 9 Jan 2026

The shutdown window adds 5 business days, pushing the deadline to 9 Jan 2026. Victoria has no shutdown exclusion, so the same claim would be due on 6 Jan 2026.

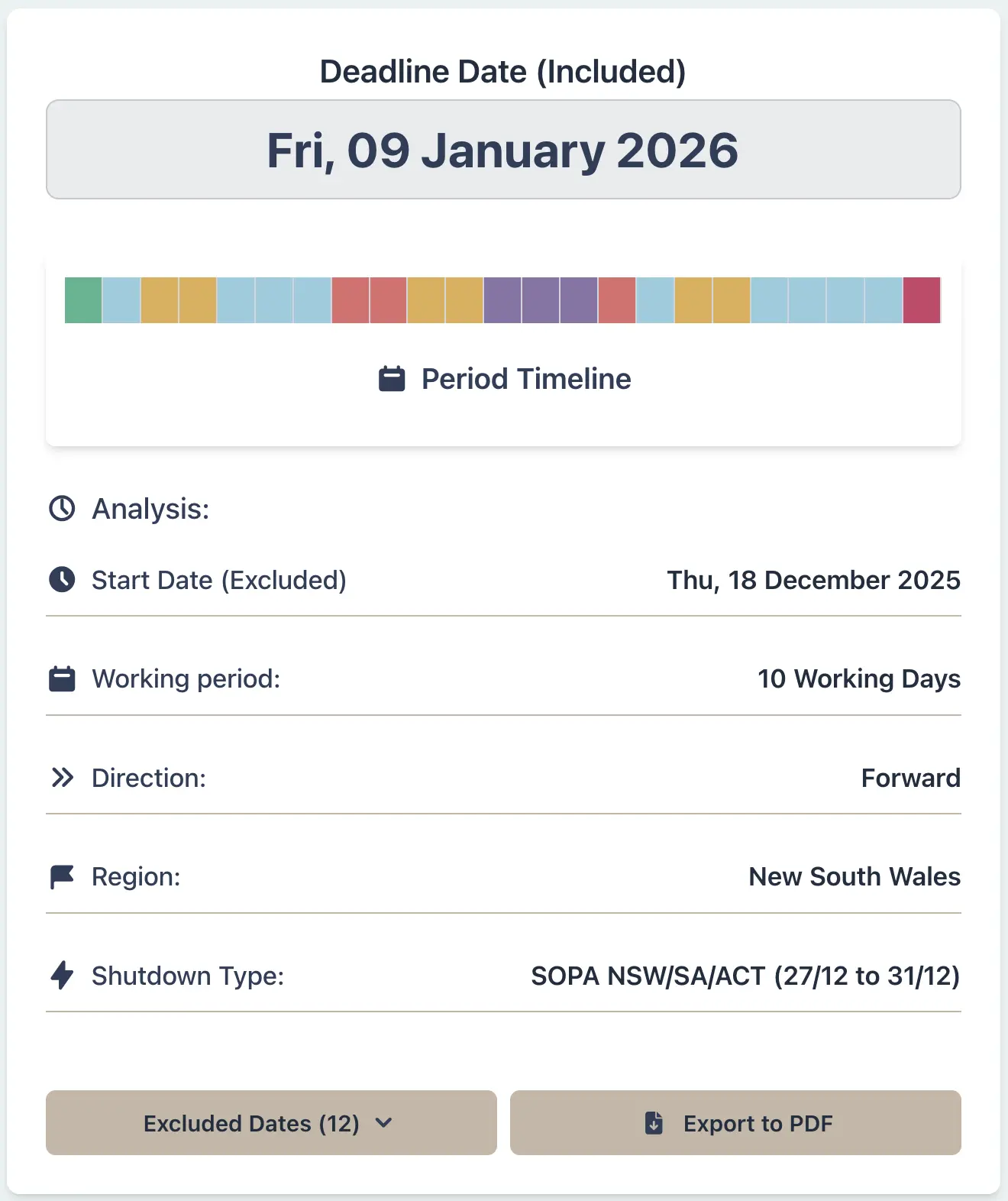

SOPA payment schedule deadline calculation for NSW

Why This Matters

  • Automatically excludes the SOPA shutdown window (27-31 December) for NSW/SA/ACT jurisdictions
  • Prevents costly errors that could result in deemed acceptance of payment claims
  • Accounts for strict SOPA timeframes that differ by state and territory
  • Provides audit trail for dispute resolution and adjudication proceedings

Litigation Solicitor:

Defence Filing Deadline During Court Vacation (VIC)

Scenario

A litigation solicitor in Melbourne is served with a statement of claim on 12 December 2025. Under the Victorian Supreme Court Rules (Order 14.05), a defence must be filed within 28 days after service. However, the Victorian court vacation period runs from 24 December to 9 January, during which time does not run for the purposes of calculating deadlines (Order 63.04). The solicitor must determine when the defence is actually due, accounting for the vacation period. Filing late would expose the client to default judgment.

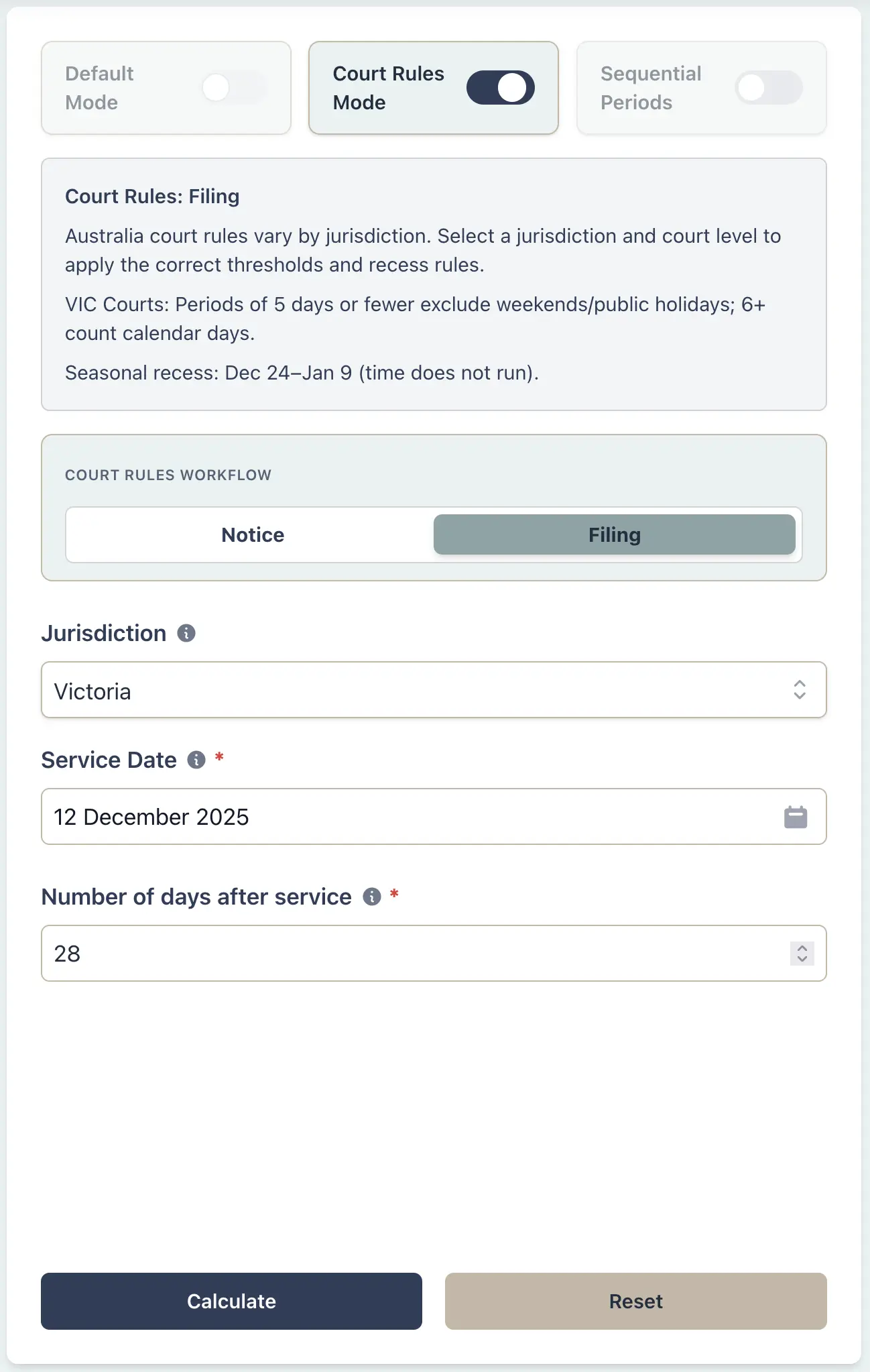

VIC court filing deadline scenario setup

Example Workflow

1
Enable Court Rules mode
2
Select "Filing" in the Court Rules workflow toggle
3
Select Victoria as the jurisdiction
4
Enter the statement of claim service date (12 December 2025)
5
Enter 28 days in "Number of days after service"
6
Court Rules mode applies the VIC court vacation automatically (24 Dec–9 Jan)
7
Click Calculate to see how time does not run during the vacation

Result Example

Statement of claim served: 12 Dec 2025
Standard deadline: 28 days = 9 Jan 2026
Court vacation: 24 Dec 2025 to 9 Jan 2026 (17 days suspended)
Actual deadline: 27 Jan 2026

The Victorian court vacation means time does not run for the entire period, extending the deadline by 17 days. The deadline then rolls forward because 26 January is Australia Day, making the filing due on 27 January. Without accounting for this suspension, the defence would appear due during the vacation when the court is closed for non-urgent matters.

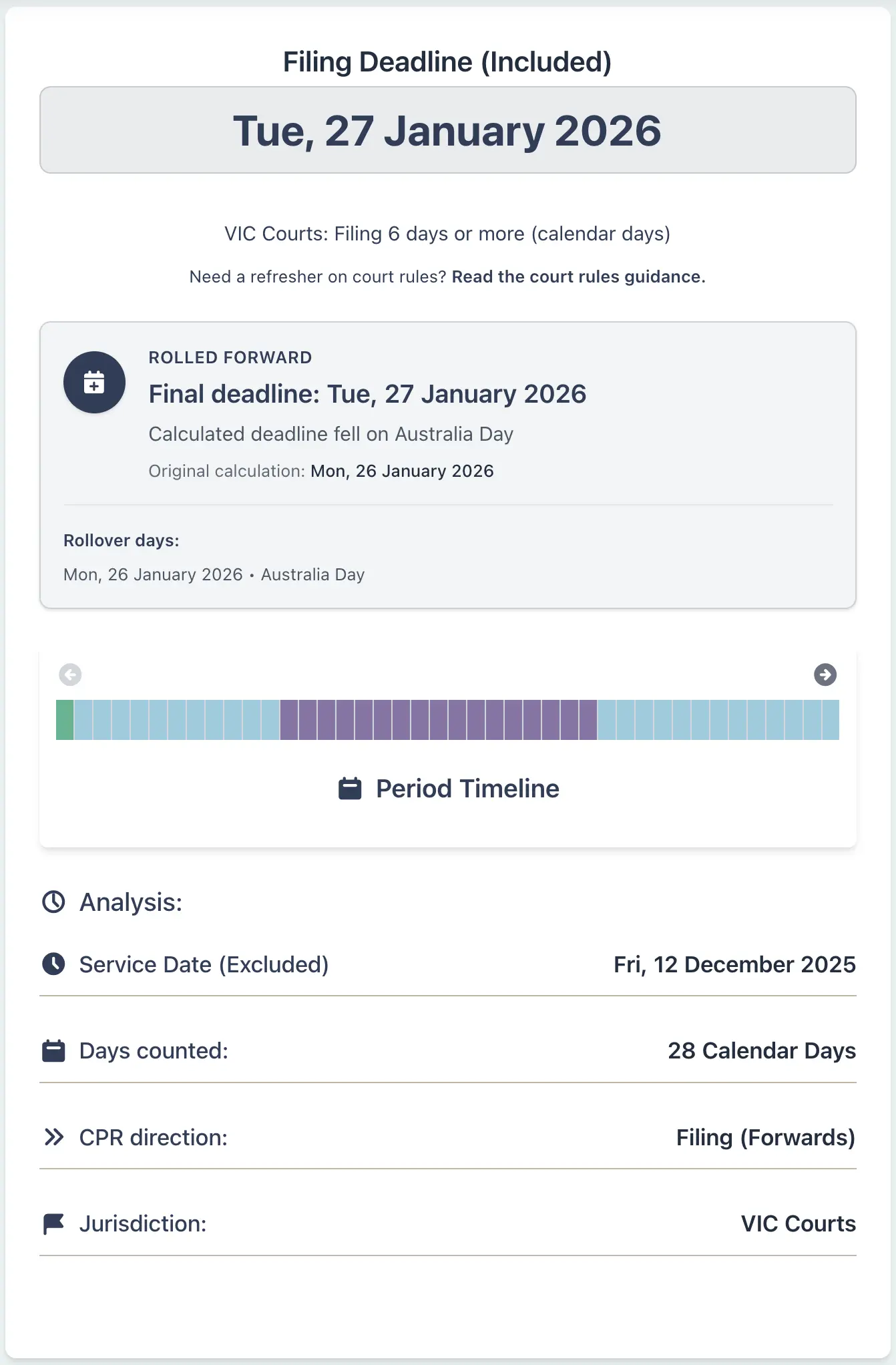

Victorian court filing deadline with vacation suspension

Why This Matters

  • Correctly applies VIC Supreme Court vacation suspension rules (Order 63.04)
  • Prevents missed deadlines that would result in default judgment
  • Accounts for the 17-day suspension period during court vacation
  • Ensures compliance with Victorian Civil Procedure Act requirements

HR Manager:

Multi-State Employment Notice Period (King's Birthday)

Scenario

An HR manager for a national retail chain needs to give a 15 working day consultation period under an enterprise agreement clause and Fair Work Act consultation obligation for proposed roster changes, starting 1 June 2026. The company has stores in both Sydney and Brisbane. In NSW and most states, the King's Birthday public holiday is observed on the second Monday of June (8 June 2026). However, Queensland moved this holiday to October to avoid school holiday conflicts. This means employees in NSW will have a different consultation deadline than those in Queensland for the same 15 working day period.

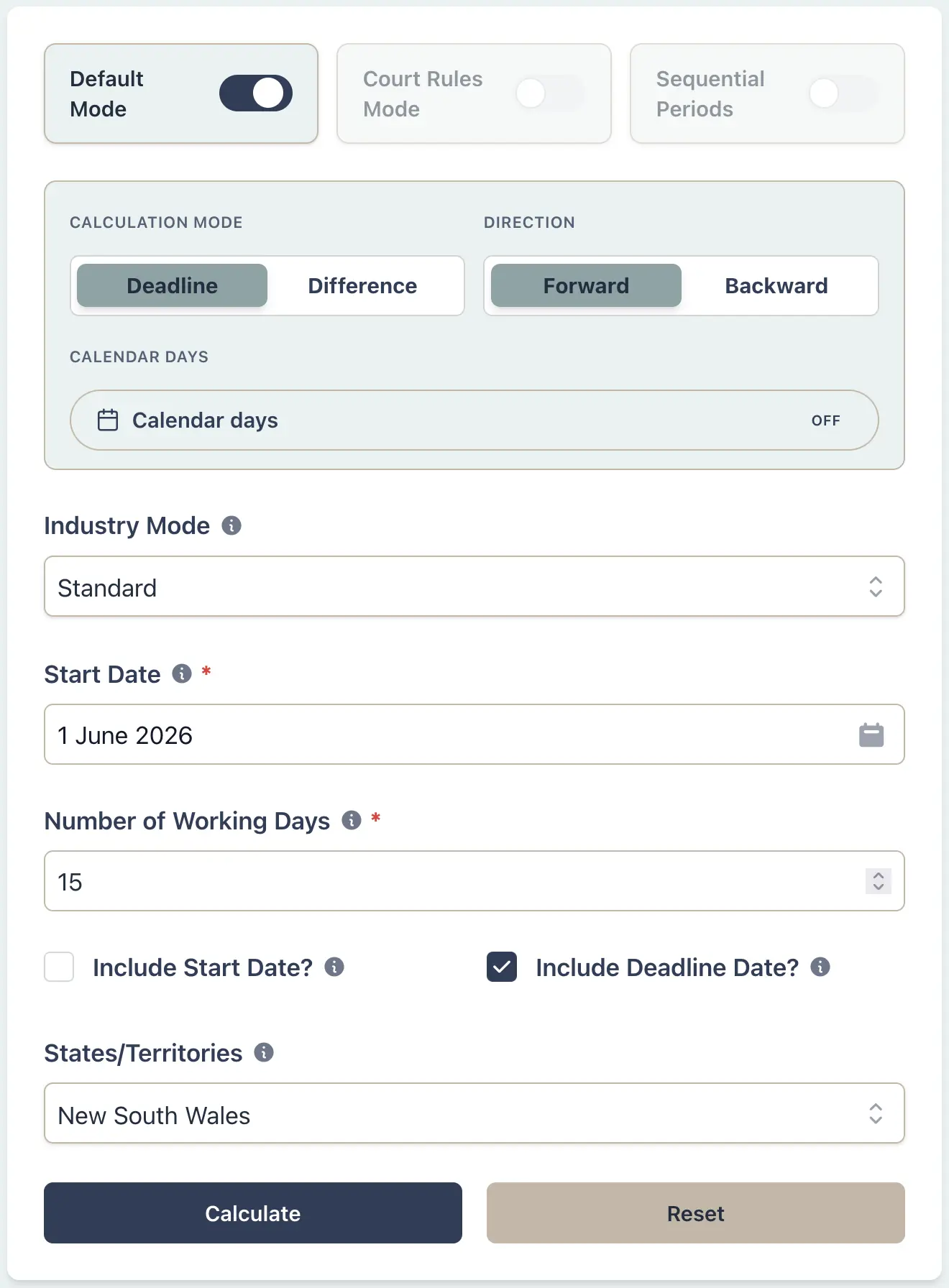

Multi-state King's Birthday scenario setup

Example Workflow

1
Select Deadline Mode in the calculator
2
Enter the consultation notice date (1 June 2026)
3
Add 15 working days for the consultation deadline
4
Leave "Include start date" unchecked
5
Keep "Include end date" checked
6
Select NSW to observe King's Birthday on 8 June 2026 (second Monday)
7
Compare with QLD where King's Birthday is in October (not June)
8
Click Calculate to see the deadline accounting for the public holiday

Result Example

Notice issued: 1 June 2026
NSW deadline: 23 June 2026 (excludes King's Birthday 8 June)
QLD deadline: 22 June 2026 (King's Birthday not in June)

The three-day difference highlights the importance of jurisdiction-specific calculations for multi-state employers. Western Australia also varies (King's Birthday set by proclamation, usually late September/October), while most other states follow the second Monday of June rule.

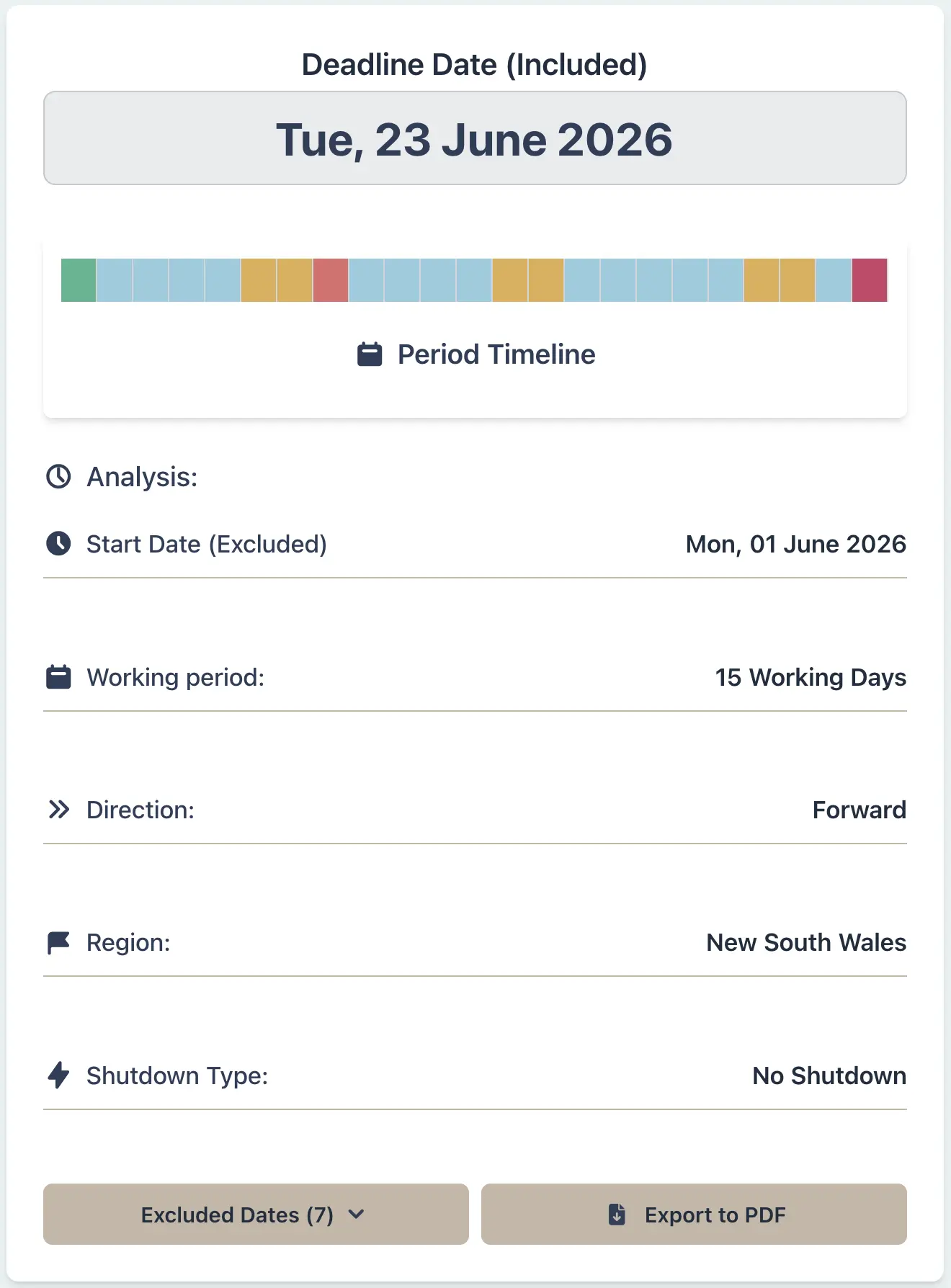

King's Birthday multi-state deadline comparison

Why This Matters

  • Correctly accounts for King's Birthday on different dates across states
  • Prevents confusion for multi-state employers with staff in different jurisdictions
  • Ensures compliance with state-specific public holiday calendars
  • Highlights the importance of jurisdiction selection for accurate calculations

Construction Manager:

Contract Milestone Across Melbourne Cup Day

Scenario

A construction manager oversees a large infrastructure project with work sites in both metropolitan Melbourne and regional Ballarat. A contract variation notice is issued on 28 October 2025, and subcontractors have 10 working days to respond. Melbourne Cup Day (first Tuesday of November - 4 November 2025) is a public holiday in metropolitan Melbourne and some regional areas of Victoria, but not in Ballarat for this scenario. This creates a deadline discrepancy: the Melbourne crew has until 12 November, while the Ballarat crew's deadline is 11 November.

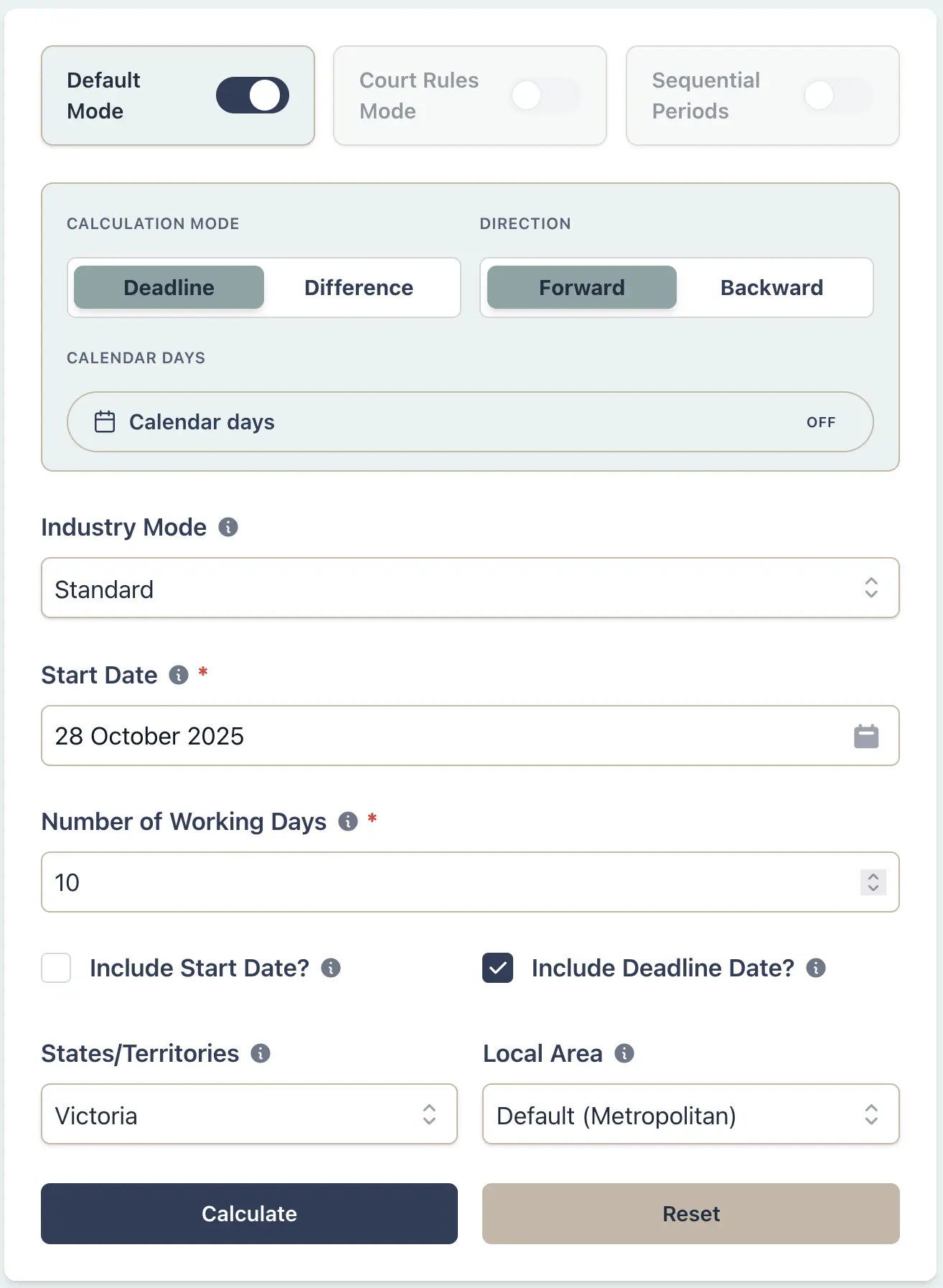

Melbourne Cup Day multi-site scenario setup

Example Workflow

1
Select Deadline Mode in the calculator
2
Enter the contract variation notice date (28 October 2025)
3
Add 10 working days for the contractor response deadline
4
Leave "Include start date" unchecked
5
Keep "Include end date" checked
6
Select Victoria as the jurisdiction
7
Note: Melbourne Cup Day (4 November 2025) applies only to metro Melbourne
8
Click Calculate - the holiday is included for VIC selection
9
For regional sites (e.g., Ballarat in this example), the deadline would be one day earlier

Result Example

Variation notice: 28 Oct 2025
Metro Melbourne deadline: 12 Nov 2025 (excludes Cup Day)
Ballarat deadline: 11 Nov 2025 (Cup Day not observed)

Melbourne Cup Day (4 November) is a public holiday only in defined metropolitan areas and some regional councils that choose to observe it. In this scenario, Ballarat does not observe the holiday, creating a one-day difference in working day calculations for the same state. This is unique to Victoria and highlights the complexity of geographic boundaries within state jurisdictions.

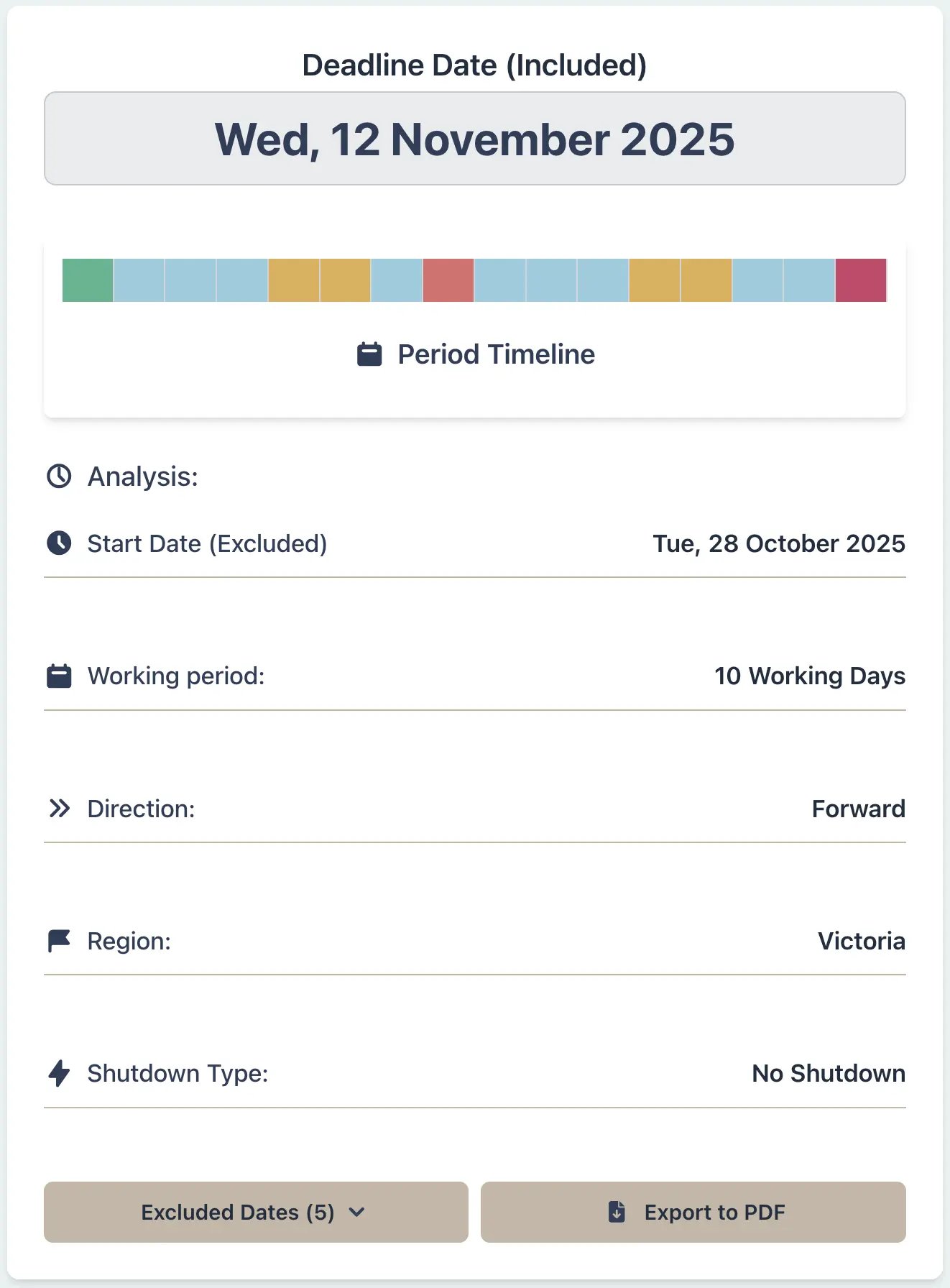

Melbourne Cup Day regional deadline comparison

Why This Matters

  • Accounts for Melbourne Cup Day (first Tuesday in November) as a VIC public holiday
  • Highlights geographic boundary issues within a single state
  • Prevents scheduling conflicts for projects spanning metro and regional areas
  • Essential for construction contracts with crews working across multiple LGAs

Conveyancer:

Property Settlement Spanning Christmas (NSW vs SA)

Scenario

A conveyancer is handling property settlements in both Sydney and Adelaide with contracts exchanged on 8 December 2025. Both contracts specify settlement 20 business days after exchange, but banking and PEXA settlement windows tighten around late December. On 26 December, NSW observes Boxing Day while South Australia observes Proclamation Day, so the same date is a public holiday in both states but for different reasons. The conveyancer needs to align settlement dates with bank availability and settlement agent workflows while applying the correct state holiday rules.

Property settlement deadline scenario setup

Example Workflow

1
Stay in Default mode (not Court Rules or Sequential) with Deadline selected
2
Set Industry Mode to "Conveyancing"
3
Select "Contract dates (Settlement/Finance)" as the conveyancing type
4
Select NSW under States/Territories
5
Enter the contract exchange date (8 December 2025) as the Start Date
6
Leave "Exclude Dec 27–31 from business days" unchecked unless you need the shutdown applied
7
Click Calculate to determine the settlement date

Result Example

Contract exchange: 8 Dec 2025
Settlement period: 20 business days
NSW settlement date: 8 Jan 2026 (excludes Boxing Day)
SA settlement date: 8 Jan 2026 (excludes Proclamation Day)

While both states have the same result in this example (because they both observe a public holiday on 26 December), the operational issue is bank and PEXA availability around the Christmas period. The holiday names differ by state, but the practical impact is the same: settlement windows tighten, and cross-border matters need careful date checking.

Conveyancing settlement calculation NSW vs SA

Why This Matters

  • Aligns settlement dates with bank and PEXA availability around late December
  • Applies standard conveyancing shutdown period exclusions where appropriate
  • Prevents settlement date disputes between vendors and purchasers
  • Ensures compliance with state-specific contract terms and public holiday calendars

Contracts Administrator:

Contract Notice Period Spanning Show Days (QLD)

Scenario

A contracts administrator for a mining company is issuing contract variation notices to contractors working on projects in both Brisbane and the Gold Coast. The contract adopts local public holidays at the place of work, and the notice is issued on 10 August 2025 with contractors required to respond within 14 working days. In Queensland, the Royal Queensland Show (Ekka) is observed statewide on 13 August 2025 (Wednesday of the second week of August). The Gold Coast also has a local show day on 29 August 2025, which adds a second non-working day for that area. Queensland has over 70 gazetted local show days, each applying only to specific local government areas.

Queensland regional show day scenario setup

Example Workflow

1
Select Deadline Mode in the calculator
2
Enter the initial contract notice date (10 August 2025)
3
Add 14 working days for the response deadline
4
Leave "Include start date" unchecked
5
Keep "Include end date" checked
6
Select Queensland as the jurisdiction
7
Note: Royal Queensland Show (Ekka) is 13 August 2025 and applies statewide
8
Click Calculate to see the deadline with the Ekka holiday included
9
Optional: select the Gold Coast show day region to add the local holiday (29 August 2025)

Result Example

Contract notice: 10 Aug 2025
Brisbane deadline: 2 Sep 2025 (excludes Ekka 13 Aug)
Gold Coast deadline: 3 Sep 2025 (excludes Ekka + Gold Coast Show 29 Aug)

Queensland's system of show day holidays is the most complex in Australia. The Ekka date applies statewide, and regional areas can also have their own additional local show days. Each local show day is gazetted for specific LGA boundaries, creating over 70 possible variations across the state in any given year.

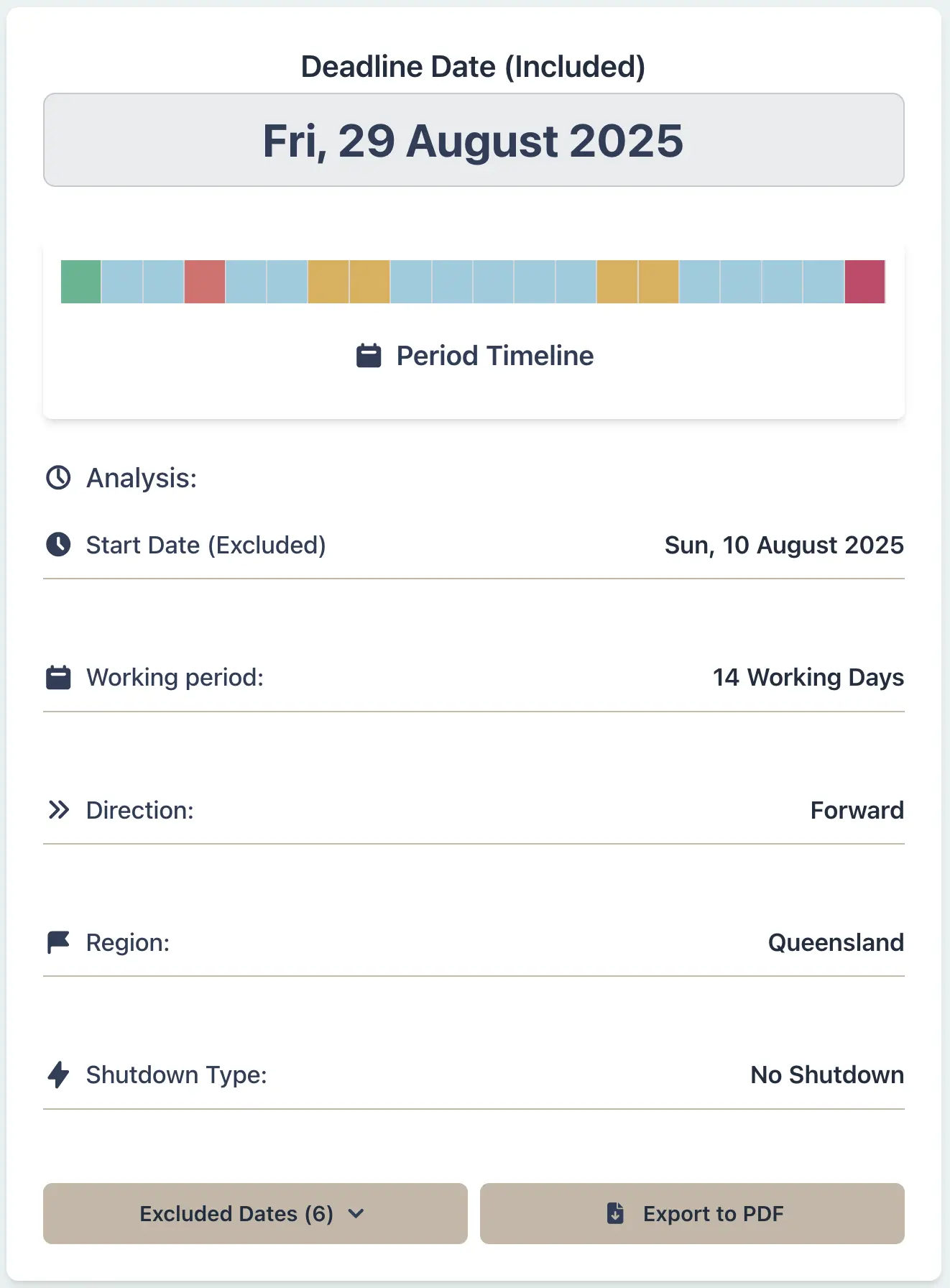

Queensland show day deadline calculation

Why This Matters

  • Applies the Ekka statewide holiday plus any local show day for the selected area
  • Highlights the complexity of 70+ local show days across Queensland
  • Prevents missed deadlines due to local government area-specific holidays
  • Essential for contracts that adopt local public holidays at the place of work

Litigation Lawyer:

Court Notice During WA Court Vacation (Longest Suspension)

Scenario

A litigation lawyer in Perth has a WA Supreme Court hearing scheduled for 27 January 2026 and must serve a 14-day notice of hearing. In WA, time does not run during the court vacation (24 December to 15 January) for Supreme and District Court matters. WA also uses a 6-day threshold: notices of 6 days or fewer are counted in working days, while 7 days or more use calendar days. The lawyer needs the correct service date before the recess.

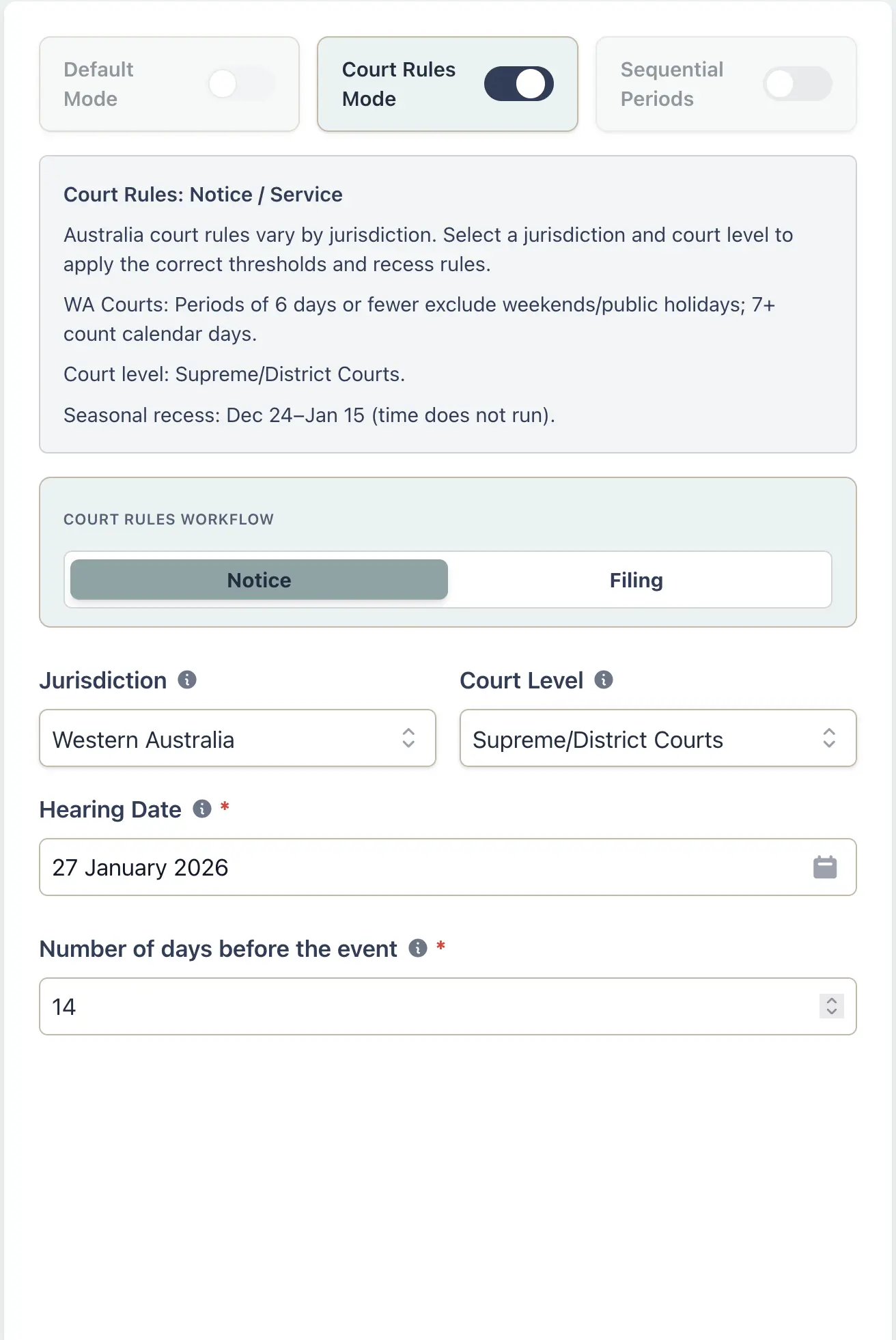

WA court vacation notice scenario setup

Example Workflow

1
Enable Court Rules mode
2
Select "Notice" in the Court Rules workflow toggle
3
Select Western Australia as the jurisdiction
4
Select the Supreme/District Courts court level
5
Enter the hearing date (27 January 2026) that the notice period runs back from
6
Enter 14 days in "Number of days before the event"
7
Court Rules mode applies the WA court vacation automatically (24 Dec–15 Jan)
8
Click Calculate to see how time does not run during the vacation

Result Example

Hearing date: 27 Jan 2026
Notice period: 14 days before hearing (calendar days)
WA court vacation: 24 Dec 2025 to 15 Jan 2026 (23 days suspended)
Service deadline: 19 Dec 2025

WA's vacation means time does not run from 24 Dec to 15 Jan, so the service deadline falls before the recess. In this example the calculated date lands on a Saturday (20 Dec), so it rolls to the prior business day. The 6-day threshold is also different to most states, which use a 5-day threshold, so short notices can behave differently in WA.

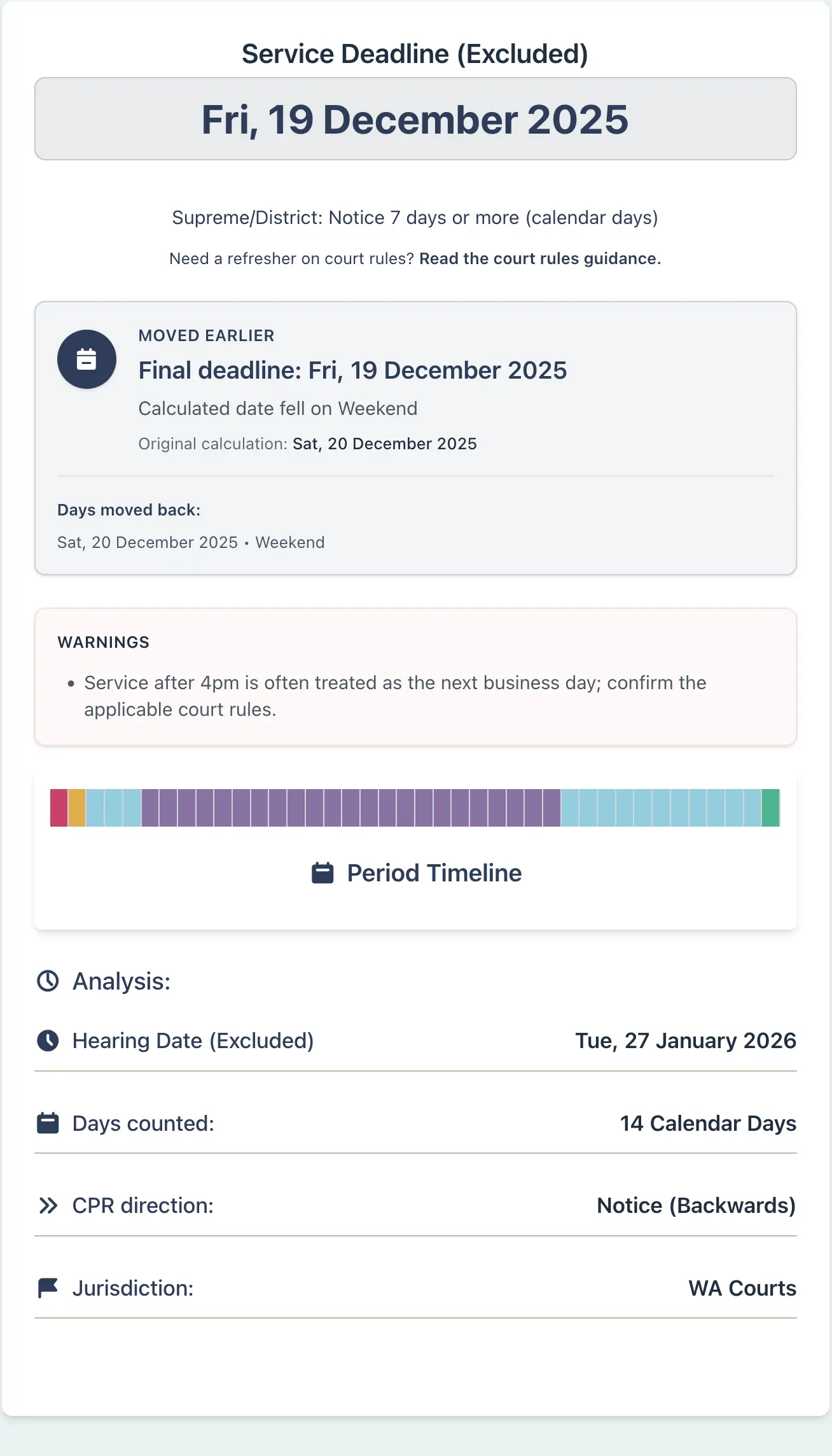

WA court vacation suspension calculation

Why This Matters

  • Applies WA's unique 23-day court vacation suspension (longest in Australia)
  • Correctly implements WA's 6-day threshold rule (vs 5 days in most states)
  • Prevents calculation errors that could result in deemed service or missed deadlines
  • Accounts for different vacation modes for Supreme/District vs Magistrates courts
